Townhill Park Regeneration

Townhill Park is a long-running estate renewal programme in east Southampton that is now moving through a second delivery model. One completed housing plot, a new community green and road improvements are in place, while Abri and Sovereign Network Group (SNG) are designing affordable housing across five further plots.

Research snapshot

At a glance

Project scaleOver 600-home programme; 56 homes delivered

Published scope summary

Delivery window2012 onward; Plot 2 application targeted autumn 2026

Publicly stated timeframe

Focus districtsSO18 postcode district

Property-market context

Research confidenceHigh

18 sources reviewed, last verified 20 Jul 2026

Computer-generated view of SNG's proposed affordable homes on Plot 2 at Townhill Park
Project visualSNG's current design-stage visual for Plot 2. The scheme may change following consultation and planning review. Source

Project timeline

  1. Latest updatePlot 2 consultation closes

    SNG moved into feedback review and design finalisation, with a planning application intended for autumn 2026

    Source
  2. Plot 2 construction could begin

    SNG's consultation programme shows an early-2028 start only if planning permission is granted

    Source
  3. Plot 2 planning submission intended

    SNG intends to submit a detailed application after reviewing consultation feedback; the date is a target

    Source
  4. Plot 2 consultation opens

    SNG opened consultation on around 110 affordable homes and published design, landscape and access material

    Source
Show full timeline (15 earlier milestones)Hide earlier milestones
  1. SNG appointed for Plot 10

    SNG added the Copse Road and Longmead Road family-housing plot to its Townhill Park work

    Source
  2. Five plots remain pre-planning

    Council budget and scrutiny records said Abri and SNG were developing applications, with construction then forecast from 2027

    Source
  3. SNG selected for Plots 2 and 9

    The council announced SNG for an indicative 170 affordable homes across the two plots

    Source
  4. Abri selected for Plots 5 and 6

    Abri became preferred provider for up to 189 affordable homes, subject to design, planning and agreements

    Source
  5. Council resets the delivery route

    Cabinet ended the Drew Smith/Countryside pre-construction arrangement and moved Plots 2 and 9 to the Affordable Housing Framework

    Source
  6. Brownfield demolition funding announced

    A GBP1.08 million government award supported clearance at Benhams Road and Rowlands Walk

    Source
  7. Townhill Green opens

    The new community green added play, exercise, planting and social space at the centre of the estate

    Source
  8. Plot 9 site assembly progresses

    Cabinet approved compulsory-purchase action for Rowlands Walk after the council acquired the remaining known property interest

    Source
  9. Meggeson Avenue works delivered

    Road, footway, access and traffic-calming improvements were completed in phases

    Source
  10. Plot 1 housing completed

    Roundhill Close delivered 56 council homes: 50 flats and six houses

    Source
  11. Delivery and demolition powers extended

    The council authorised further demolition procurement and land disposal steps to progress masterplan plots

    Source
  12. Hybrid planning application conditionally approved

    Application 15/01856/OUT covered 665 homes: 276 in a detailed first phase and 389 in later outline phases, plus open space and retail

    Source
  13. Modified Central Park framework approved

    Cabinet approved the framework vision following further consultation, while recognising that later studies could change individual proposals

    Source
  14. Regeneration principles approved

    Cabinet approved the principles of a three-phase Townhill Park masterplan and authorised work toward implementation

    Source
  15. Framework consultation begins

    The council began resident consultation on options for the estate-wide regeneration framework

    Source
Reviewed monthly while the project remains active. The latest verified update is shown first, followed by future targets and earlier milestones.

Townhill Park is a long-running estate renewal programme in east Southampton that is now moving through a second delivery model. One completed housing plot, a new community green and road improvements are in place, while Abri and Sovereign Network Group (SNG) are designing affordable housing across five further plots. The latest public milestone is the close of SNG's Plot 2 consultation on 16 July 2026; a planning application is intended for autumn 2026, so the proposed 110 homes are not yet approved or under construction.

The programme began as a council-led replacement of ageing housing and a redesign of streets, open space and local facilities. Southampton City Council still describes an ambition for more than 600 energy-efficient homes, but that figure is a programme-level ambition rather than a current construction total. The 2016 hybrid application covered 665 dwellings across the estate; later procurement changes, redesigns and plot-by-plot partnerships mean current proposals must be read separately.

The delivery position is mixed. Roundhill Close delivered 56 homes in April 2019, although remedial building-safety work has continued. Townhill Green opened in 2022, and the council reports GBP3.75 million of neighbourhood works including the green and traffic calming. By contrast, the five plots now assigned to Abri and SNG remain at design or pre-planning stage.

Project facts

FieldEvidence-backed position
ProgrammeTownhill Park Estate Regeneration
LocationTownhill Park, east Southampton, principally around Meggeson Avenue, SO18
Programme leadSouthampton City Council
Current delivery partnersAbri on Plots 5 and 6; SNG on Plots 2, 9 and 10
Long-term housing ambitionMore than 600 replacement and additional energy-efficient homes across the estate
Completed housing56 homes at Plot 1, Roundhill Close, completed in April 2019
Current five-plot pipelineCouncil scrutiny material says between 350 and 400 homes, all still pre-planning in spring 2026
Latest detailed proposalAround 110 affordable homes at Plot 2, split between social rent and shared ownership
Completed public realmTownhill Green, Meggeson Avenue road and footway works, traffic calming and access improvements
Current phasePart delivered; five further plots in design and pre-planning
Evidence cut-off20 July 2026

The exact estate programme boundary should be taken from the council's plot plans and individual planning applications, not from a single marketing outline. SNG's June 2026 consultation material maps Plots 2 and 9 within the wider estate, while the council's regeneration page also tracks Plots 5, 6, 7, 10, 12 and 13 at different stages.

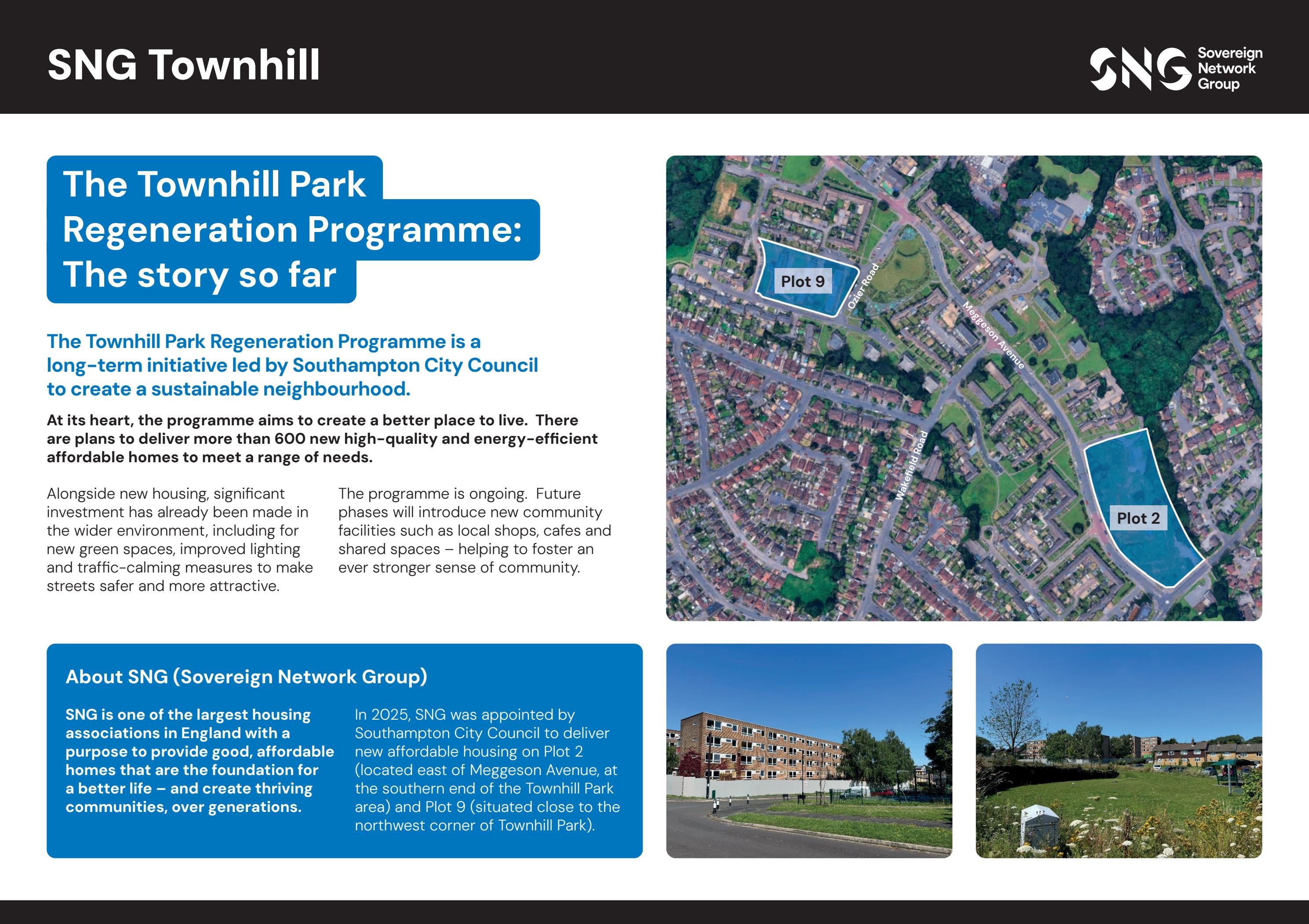

SNG consultation board mapping Plots 2 and 9 within the Townhill Park regeneration programme
SNG consultation board mapping Plots 2 and 9 within the Townhill Park regeneration programme

The June 2026 SNG consultation board identifies Plot 2 east of Meggeson Avenue and Plot 9 at Rowlands Walk. Image source: SNG consultation boards.

Why the delivery route changed

Southampton approved a regeneration framework in 2012 and conditional planning approval for a 665-home hybrid scheme in May 2016. The detailed first phase contained 276 homes and later phases accounted for 389 homes in outline. That permission records the original scale, but it should not be read as proof that every current plot design remains approved.

Delivery subsequently slowed. In February 2024 the council ended its pre-construction route with Drew Smith, later Countryside Partnerships, citing the contractor's withdrawal, higher costs and funding timing. Plots 2 and 9 were moved into the council's Affordable Housing Framework, with Plot 10 considered separately. This reset is central to the current position: registered providers now design and deliver the principal plots, and new or updated planning applications are required.

Abri was selected in late 2024 for Plots 5 and 6. The council's 2025 Housing Delivery Test Action Plan describes up to 189 homes and a phased completion target by the end of 2029, but this remains dependent on planning and delivery agreements. SNG was then appointed for Plots 2 and 9, described by the council in September 2025 as around 170 affordable homes across those two plots. That combined estimate is not a fixed consented total: Plot 2 is now shown as around 110 homes, while SNG says the Plot 9 mix is still being developed.

What is delivered and what is still proposed

ComponentStatus checked 20 July 2026Current evidence
Plot 1, Roundhill CloseDelivered; remedial work continuing56 council homes, comprising 50 flats and six three-bedroom houses, completed in April 2019. The council later identified communal-door, alarm and fire-stopping issues and reports corrective work.
Townhill Green, Plot 8DeliveredCommunity-designed green space with play, outdoor gym, shelters, planting and accessible paths; opened in 2022.
Meggeson Avenue improvementsDeliveredRoad and footway resurfacing, traffic calming and access measures were completed as part of a programme supported by Homes England and developer funding.
Plots 5 and 6Design / pre-planningAbri is progressing up to 189 homes. A 2026 council budget report said planning applications were expected during 2026 and that Abri was tendering for a contractor.
Plot 2Consultation complete; pre-applicationSNG consulted on around 110 affordable houses, maisonettes and apartments from 25 June to 16 July 2026. Social rent and shared ownership are proposed.
Plot 9, Rowlands WalkEarly designSNG is working with the council on the housing mix. A precise current total and programme have not been published.
Plot 10, Copse Road / Longmead RoadProvider appointed; early designSNG was appointed on 15 June 2026 to bring forward family affordable housing. The current total and tenure mix have not been published.
Plot 7, Kingsdown WayDecommissioning / future plotCouncil material records decommissioning, but no current planning application or construction start has been verified.
Plots 12 and 13Under reviewThe council has been considering whether existing blocks should be improved or redeveloped; there is no confirmed timetable.

The labels above deliberately separate delivered work, design work and planning status. Appointment of a housing provider does not equal planning consent, and clearance of a site does not mean housing construction has started.

Plot 2 is the clearest current proposal

SNG's Plot 2 consultation ran from 25 June to 16 July 2026. The provider says it is now considering feedback and intends to submit a planning application in autumn 2026. The proposal contains around 110 affordable homes east of Meggeson Avenue, including houses, maisonettes and apartments. Most buildings are shown at two storeys, with a seven-storey residential building at the southern corner.

The consultation boards identify social rent and shared ownership, private gardens for houses, balconies for maisonettes and apartments, three principal landscaped spaces and a pedestrian route to Meggeson Avenue. Four parking areas are proposed with access from Meggeson Avenue, Townhill Way and Paulet Close. These are design-stage details, not approved obligations.

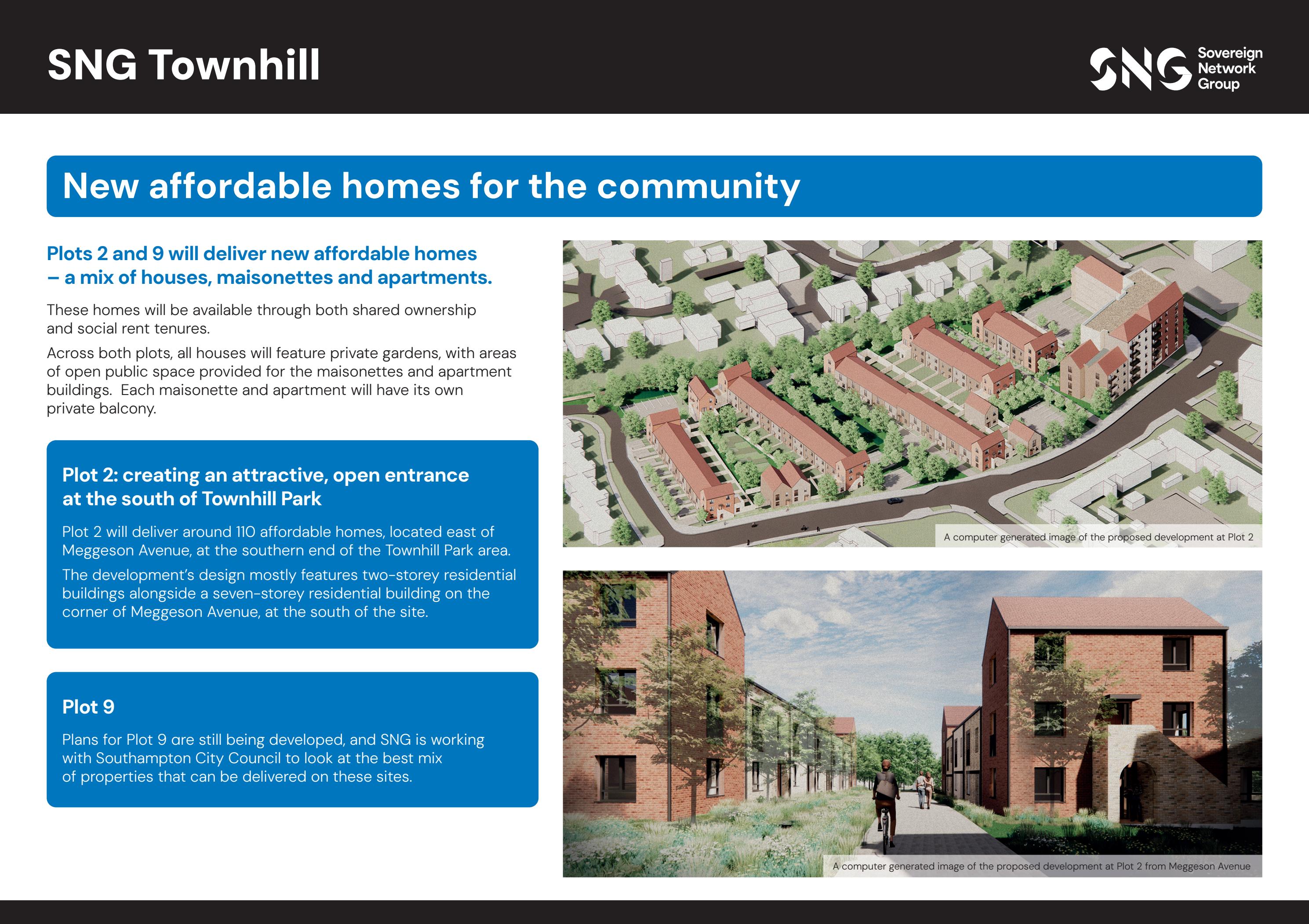

SNG consultation board showing the proposed Plot 2 housing mix and computer-generated layout
SNG consultation board showing the proposed Plot 2 housing mix and computer-generated layout

SNG's June 2026 board presents around 110 homes at Plot 2 and confirms that the Plot 9 mix is still being developed. Image source: SNG consultation boards.

SNG's target programme shows a planning application later in 2026 and construction from early 2028 if permission is granted. Both dates are conditional. No verified main works contract or start-on-site announcement for Plot 2 was found at the evidence cut-off.

Funding, land and enabling work

The programme combines council land, registered-provider investment, housing funding and enabling grants. In October 2023 the council announced a GBP1.08 million Brownfield Land Release Fund award to clear buildings at Benhams Road and Rowlands Walk. The council then estimated those cleared sites could support 220 homes. That estimate predates the current provider designs and should not be added to newer plot totals.

Site assembly has also required tenant relocation and, for Rowlands Walk, compulsory-purchase powers. The November 2022 Plot 9 decision recorded the council's use of a compulsory purchase order to secure the full site. Initial Demolition Notices across the wider estate do not themselves set a demolition date; the council explains that a final notice requires planning permission and a set demolition programme.

Completed neighbourhood investment matters to the delivery story. Townhill Green opened in 2022 with play, exercise and community features. Meggeson Avenue works improved crossings, surfaces and traffic calming. These assets are already usable, unlike the housing on the five current provider plots.

Housing and property context

The clearest direct effect is a planned increase in affordable housing choice, subject to planning and construction. Plot 2 proposes social-rent and shared-ownership homes, while the council says the five active provider plots should retain nomination rights for households on the housing register. The tenure and final count must still be checked plot by plot when applications are submitted.

Any effect on private sale prices or rents is qualitative and cannot be isolated from wider Southampton market conditions. New homes, improved open space and safer streets may change how individual locations are perceived, while demolition, relocation and multi-year construction can create disruption. The evidence reviewed does not support a numerical price, rent or rental return forecast.

Property-level research should check the precise plot boundary, tenure, service charges, parking rights, building height, construction phasing, access changes and distance from future works. Existing residents should also use the council's current relocation and demolition notices rather than relying on older masterplan dates.

Risks and points to monitor

Watch pointWhy it mattersEvidence to monitor
Planning remains outstandingThe five principal provider plots were still pre-planning in the latest council scrutiny update.Plot 2 application expected in autumn 2026; later applications for Plots 5, 6, 9 and 10.
Totals describe different scopesThe 665-home 2016 consent, more-than-600 programme ambition, 350-400 five-plot pipeline and individual plot figures are not interchangeable.Use the latest decision or application for each plot and avoid summing superseded estimates.
Delivery dates are conditionalPlot 2's early-2028 start and Abri's end-2029 completion are targets, not guarantees.Planning decisions, provider contracts, funding agreements and start-on-site notices.
Tenure detail can changeAffordable housing can include social rent, affordable rent and shared ownership in different proportions.Application schedules, legal agreements and provider announcements.
Resident relocation continuesDecommissioning and demolition notices affect existing households before construction.Current council decommissioning programme, final notices and rehousing updates.
Existing-home remediationRoundhill Close is occupied but corrective building work has been required.Council updates confirming completion and sign-off of remedial work.
Community facilities are not all securedThe original framework included shops, community uses and public-realm changes, but later plot proposals may differ.Planning obligations, replacement retail plans and confirmed delivery funding.

Detailed project history

DateMilestoneWhat happenedSource
September 2011Framework consultation beginsThe council began resident consultation on options for the estate-wide regeneration framework.2012 masterplan decision record
12 March 2012Regeneration principles approvedCabinet approved the principles of a three-phase Townhill Park masterplan and authorised work toward implementation.Cabinet issue history
13 November 2012Modified Central Park framework approvedCabinet approved the framework vision following further consultation, while recognising that later studies could change individual proposals.Phase 1 scheme approval
3 May 2016Hybrid planning application conditionally approvedApplication 15/01856/OUT covered 665 homes: 276 in a detailed first phase and 389 in later outline phases, plus open space and retail.Planning panel record
21 March 2017Delivery and demolition powers extendedThe council authorised further demolition procurement and land disposal steps to progress masterplan plots.Townhill Park next-steps decision
April 2019Plot 1 housing completedRoundhill Close delivered 56 council homes: 50 flats and six houses.Roundhill Close project page
2020Meggeson Avenue works deliveredRoad, footway, access and traffic-calming improvements were completed in phases.Townhill Park road improvements
2022Townhill Green opensThe new community green added play, exercise, planting and social space at the centre of the estate.Townhill Green
15 November 2022Plot 9 site assembly progressesCabinet approved compulsory-purchase action for Rowlands Walk after the council acquired the remaining known property interest.Plot 9 CPO decision
10 October 2023Brownfield demolition funding announcedA GBP1.08 million government award supported clearance at Benhams Road and Rowlands Walk.Brownfield Land Release Fund announcement
6 February 2024Council resets the delivery routeCabinet ended the Drew Smith/Countryside pre-construction arrangement and moved Plots 2 and 9 to the Affordable Housing Framework.Future delivery decision
November 2024Abri selected for Plots 5 and 6Abri became preferred provider for up to 189 affordable homes, subject to design, planning and agreements.Housing Delivery Test Action Plan
September 2025SNG selected for Plots 2 and 9The council announced SNG for an indicative 170 affordable homes across the two plots.Council appointment announcement
February 2026Five plots remain pre-planningCouncil budget and scrutiny records said Abri and SNG were developing applications, with construction then forecast from 2027.HRA budget 2026/27
15 June 2026SNG appointed for Plot 10SNG added the Copse Road and Longmead Road family-housing plot to its Townhill Park work.SNG Plot 10 announcement
25 June 2026Plot 2 consultation opensSNG opened consultation on around 110 affordable homes and published design, landscape and access material.SNG Plot 2 consultation
16 July 2026Plot 2 consultation closesSNG moved into feedback review and design finalisation, with a planning application intended for autumn 2026.SNG Townhill update
Autumn 2026 targetPlot 2 planning submission intendedSNG intends to submit a detailed application after reviewing consultation feedback; the date is a target.SNG Townhill next steps
Early 2028 targetPlot 2 construction could beginSNG's consultation programme shows an early-2028 start only if planning permission is granted.SNG consultation boards

Current assessment

Townhill Park has tangible completed infrastructure and housing, but the main next wave is not yet on site. The strongest evidence is that 56 homes and Townhill Green are delivered; Abri and SNG control a five-plot pre-planning pipeline; Plot 2 has reached public consultation with around 110 homes; and SNG has only recently taken on Plot 10. Future updates should focus on application references, tenure schedules, legal agreements, contractor appointments and verified starts rather than repeating programme ambitions as delivered supply.

The report should be updated when the Plot 2 application is registered, when Abri submits applications for Plots 5 and 6, when SNG publishes the Plot 9 and Plot 10 mixes, or when the council confirms a current route for Plots 7, 12 and 13.

Verification
